71、The()creates opportunities for more direct Integration of the physical world into computer-based systems,resulting in efficiently improvements,economic benefits,and reduced human exertions.
A、internet of things
B、cloud computing
C、big data
D、mobile internet
72、()is an open,distributed ledger that can record transactions between two parties efficiently and in a verifiable and permanent way.
A、Internet of things
B、Blockchain
C、Edge computing
D、Artificial intelligence
73、()are those costs that cannot Be Directly Traced To A Specific Project And Therefore Will Be Accumulated And Allocated equitably over multiple projects by some approved and documented accounting procedure.
A、Direct costs
B、Operation costs
C、Indirect costs
D、Implement costs
74、Earned value management(EVM)integrates the scope baseline with the()baseline,along with schedule baseline,to form the performance baseline,which helps the project management team assess and measure project performance and progress.
A、qulity
B、risk
C、change
D、cost
75、()risks cannot be management proactively and therefore may be assigned a management reserve.
A、Known
B、Natural
C、Unknown
D、Human
(230524)答案
66、67、【試題解析】
設甲采購X噸,在乙采購Y噸,得:
0.2X+0.4Y=16
0.5X+0.2Y=16
求:MIN(200X+300Y)。
求該方程X=20,Y=30,得乙采購30噸,最低采購成本=200*20+300*30=14000。
【參考答案】C、B
68、【試題解析】
首先定位問題,這屬于管理科學及運籌學基礎知識中的最小生成樹問題。
解法如下:
1)根據上表畫出個節點,但不建議將節點之間用線連接,如果連接后,會發現很亂,會看不清楚,考試的時候,圖盡量用鉛筆在草稿紙上畫:
2)然后用「貪心算法」,根據題干給的表,找出各短邊、用鉛筆在圖上畫出,判斷各點是否連通,最終得出下圖:
3)最后算出上圖中長度合計:0.7+0.9+1.0+0.7+0.8+0.6+0.5=5.2海里,再加上1號井離海岸最短長度為5海里,所以為10.2海里。
考試的時候做這樣的題需要耐心,建議是放到最后來做。用鉛筆畫圖是為了容易擦除。
【參考答案】D
69、70、【試題解析】
這題可以根據題干給出的表格,分別算出靜態和動態兩種情況下的累計值。

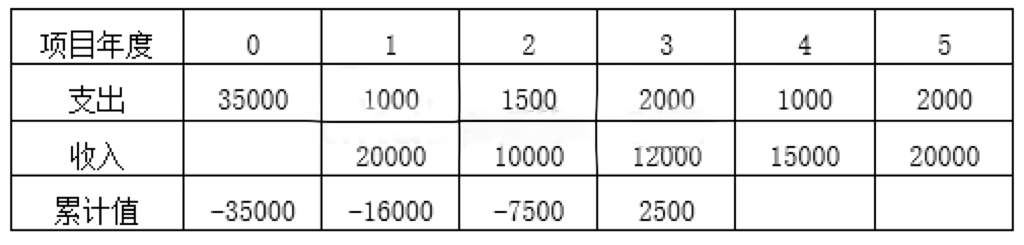

計算靜態投資回收期,算出累計值如下表:
根據靜態投資回收期計算方法,出現累計正值的年度是3;
得:(3-1)+(7500+2000)/12000≈2.8(四舍五入后保留一位小數)

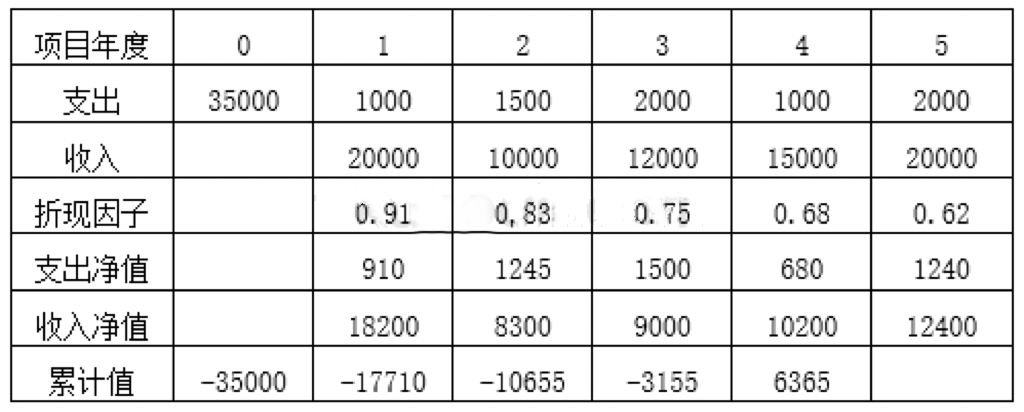

計算動態投資回收期,累計值如下表:
得(4-1)+(3155+680)/10200≈3.4(四舍五入后保留一位小數)
推薦C和B。
【參考答案】C、B
